I finally had a couple of days to play with Git integration for TM1, something I was very curious about ever since it was released in PA 2.0.7. This post describes what I’ve found so far plus the instructions on setting it up in VSCode. I hope to post more on this later.
There’s not a lot of information on the topic so far, apart from the very detailed, but quite confusing IBM documentation (unless you’re into reading standards) and a really good post by Rahul on TM1UP. I encourage you to read both.
Just to get it out of the way, Git is the most popular code version control system at the moment. Most notable hosting providers are GitHub, GitLab and Atlassian Bitbucket. And you can, of course, roll out your own internal Git server.
Let’s start with some simple use cases for Git in TM1:
TM1 model code definition includes the following by default, all exported in human-readable and editable json:
* cubes:
* dimension structure
* rules
* pickilist / drill through rules
* views
* dimensions:
* all dimension elements & hierachies
* subsets
* processes
I still have no idea on how to use tm1project resource definition despite spending literally a day trying different syntax options which tells you a lot about how sharp I am how good the documentation is. It should be very useful for describing deployment requirements, for example, to run a process XYZ after deploying these changes or for making the model more manageable, for example, to ignore all large & auto-updated dimensions from code base or code deploy (ignore customers dimension, but do include version dimension).
But I still haven’t got a clue how to use it properly, I’ll keep digging.

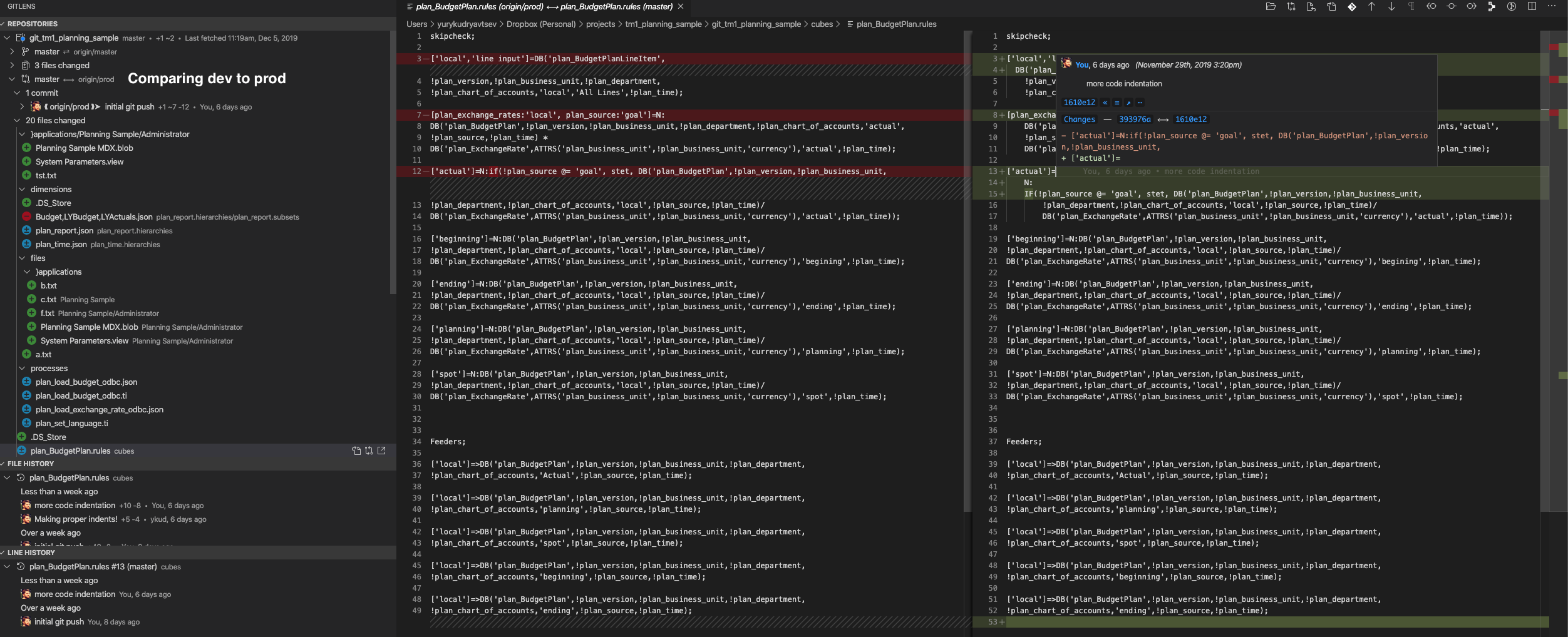

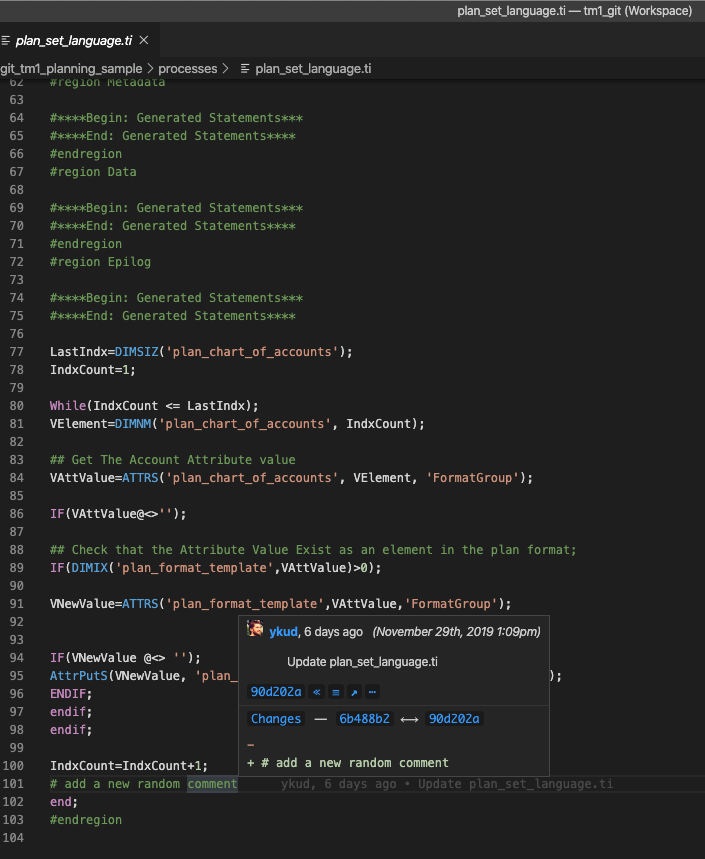

Also, I was recently introduced to GitLens and having it on some of the large rules and TIs would be so good. Imagine seeing who changed this line last, like this:
Some of Git terminology (read this for the proper introduction), I’m bastardising adapting it for TM1 purposes.
In a simple world it looks like this:
So in my current thinking if you have 3 tm1 environments (dev / test / prod):
Something like this, but with a lot more boxes :)
Once you’re done, here’s how to connect a TM1 model to Git repository.
-label
and -stashed

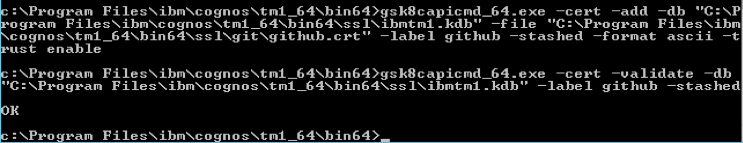

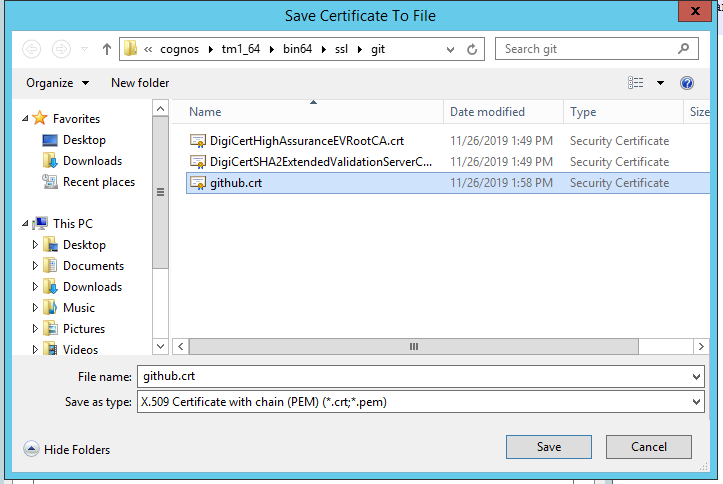

are mixed in IBM instructions)gsk8capicmd_64.exe -cert -add -db "C:\Program Files\ibm\cognos\tm1_64\bin64\ssl\ibmtm1.kdb" -file "C:\Program Files\ibm\cognos\tm1_64\bin64\ssl\git\github.crt" -label github -stashed -format ascii -trust enable
gsk8capicmd_64.exe -cert -validate -db "C:\Program Files\ibm\cognos\tm1_64\bin64\ssl\ibmtm1.kdb" -label github -stashed
###

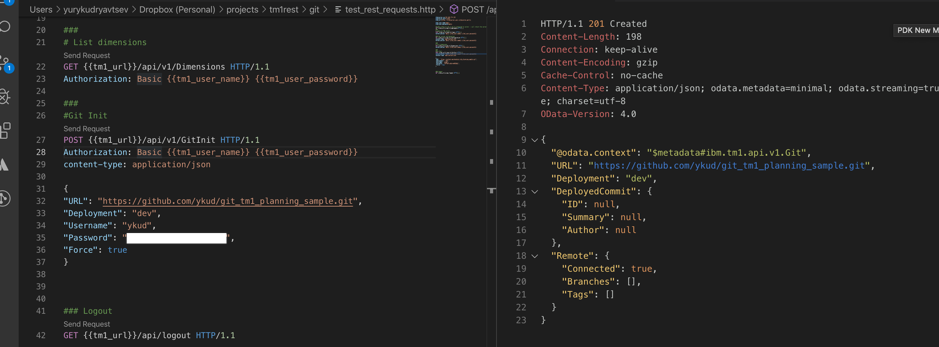

#Git Init
POST {{tm1_url}}/api/v1/GitInit HTTP/1.1
Authorization: Basic {{tm1_user_name}} {{tm1_user_password}}
content-type: application/json
{
"URL": "{{git_repo_url}}",
"Deployment": "dev",
"Username": "{{git_user_name}}",
"Password": "{{git_user_password}}",
"Force": true
}

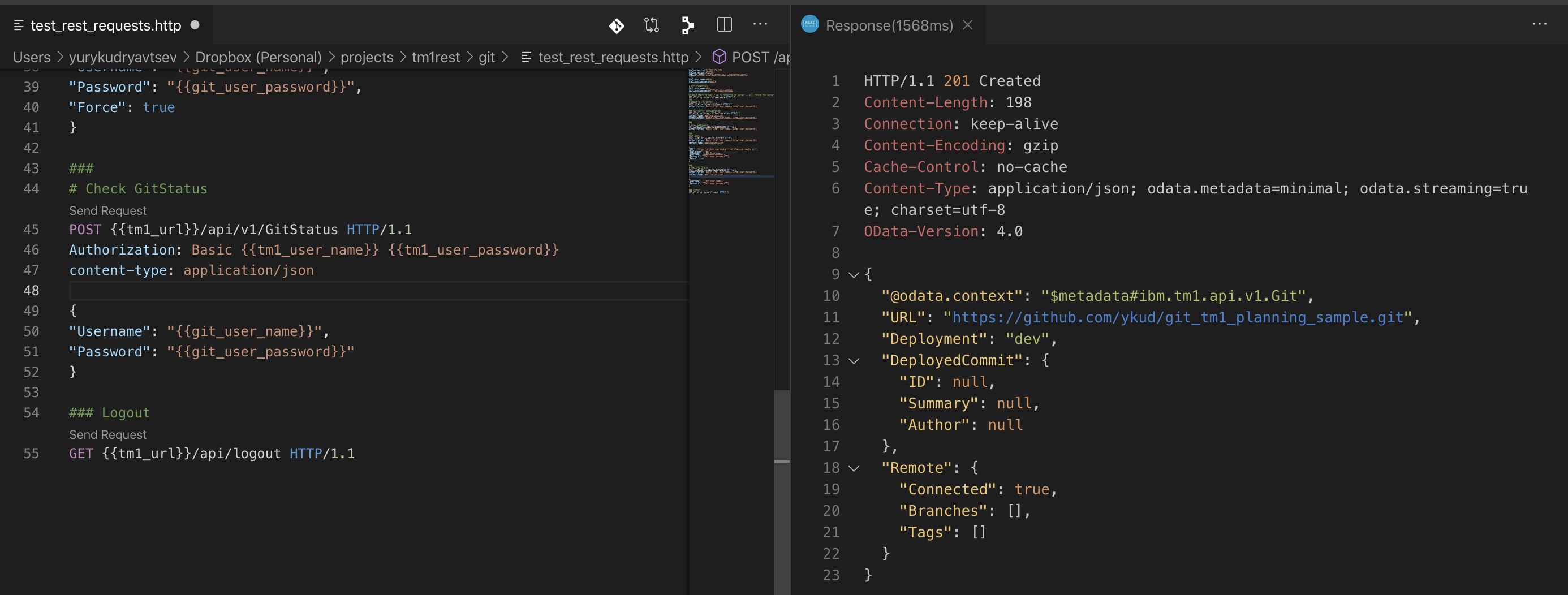

You can check your models Git status via a call like this:
###
# Check GitStatus
POST {{tm1_url}}/api/v1/GitStatus HTTP/1.1
Authorization: Basic {{tm1_user_name}} {{tm1_user_password}}
content-type: application/json
{
"Username": "{{git_user_name}}",
"Password": "{{git_user_password}}"
}
And you can disconnect it from Git via a call like this:
### Detach Git repo
POST {{tm1_url}}/api/v1/GitUninit HTTP/1.1
Authorization: Basic {{tm1_user_name}} {{tm1_user_password}}
content-type: application/json

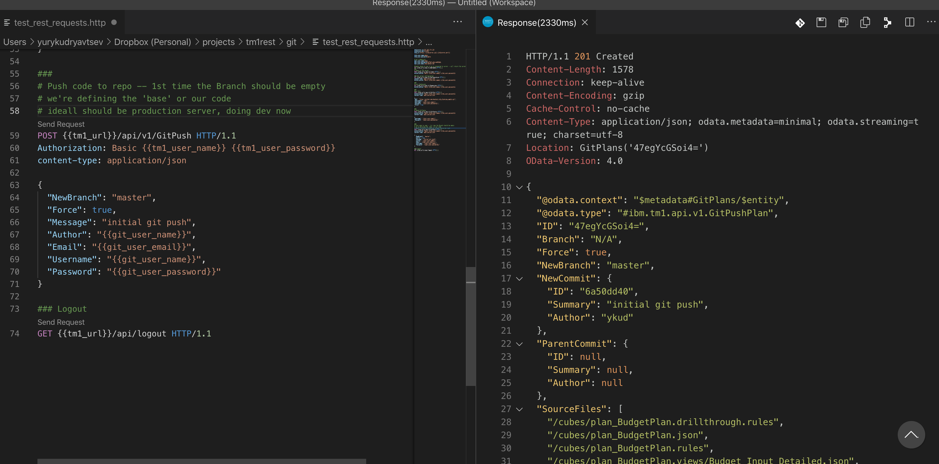

Push Tm1 model into Git via a Rest call like this. It’s a two-step process:
###
# Push code to repo -- 1st time the Branch should be empty
# we're defining the 'base' or our code
# Create a push plan that will push the whole model to git
POST {{tm1_url}}/api/v1/GitPush HTTP/1.1
Authorization: Basic {{tm1_user_name}} {{tm1_user_password}}
content-type: application/json
{
"Branch": "master",
"NewBranch":"prod",
"Force": true,
"Message": "initial git push",
"Author": "{{git_user_name}}",
"Email": "{{git_user_email}}",
"Username": "{{git_user_name}}",
"Password": "{{git_user_password}}"
}
This call lists what will happen during the push as a response (like files created/updated):
It also returns the Git plan ID in response. This is a chance to review whether these are really the changes we want in repo :)

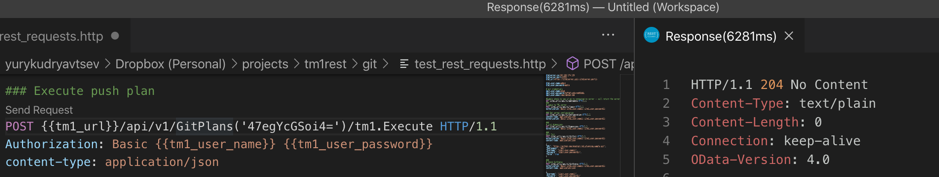

2. you then execute this plan to really push changes
@git_push_plan_id=47egYcEyQxY=
### Execute push plan
POST {{tm1_url}}/api/v1/GitPlans('{{git_push_plan_id}}')/tm1.Execute HTTP/1.1
Authorization: Basic {{tm1_user_name}} {{tm1_user_password}}
content-type: application/json

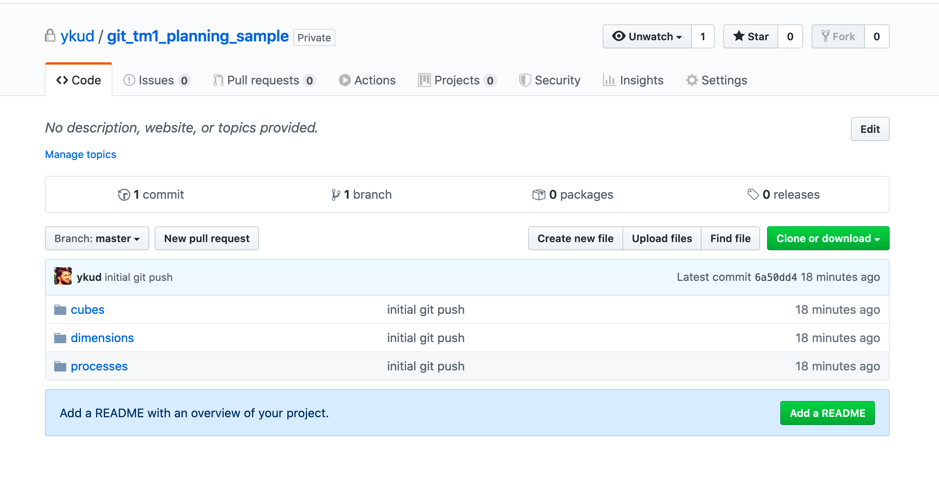

At this point your Git repository will be populated and you’d see the model in all it’s glory:

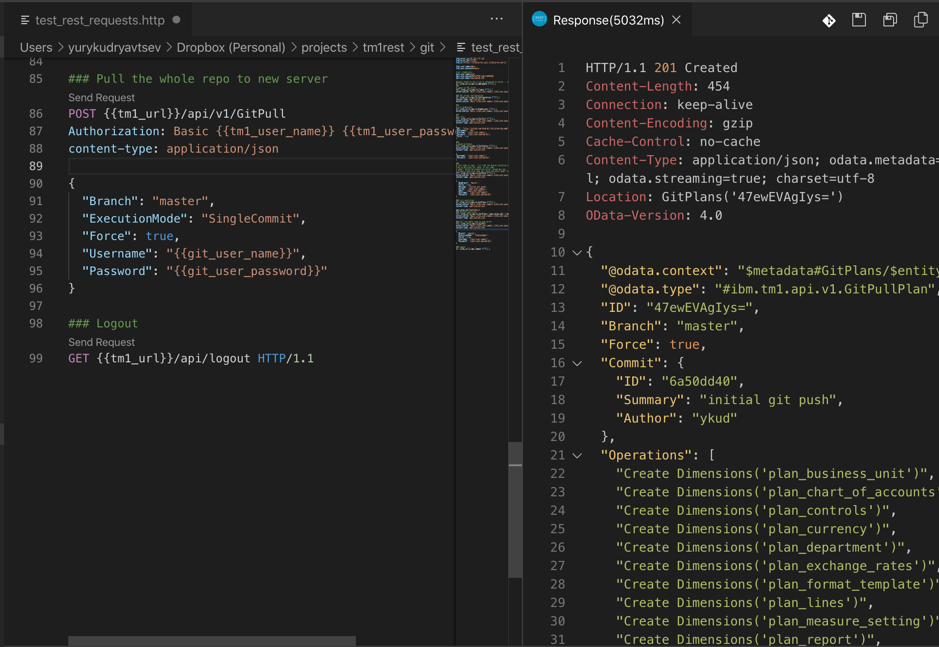

To pull changes from the repository, you create a Pull plan that will list all the changes that will happen with the model once it’s executed (note the branch parameter, this is the one we’d use to pull only specified environment or change set):
### Create pull plan
POST {{tm1_url}}/api/v1/GitPull
Authorization: Basic {{tm1_user_name}} {{tm1_user_password}}
content-type: application/json
{
"Branch": "master",
"ExecutionMode": "SingleCommit",
"Force": true,
"Username": "{{git_user_name}}",
"Password": "{{git_user_password}}"
}
A response to this Rest API call gives you preview of what’s changed between the model ‘running’ on your server and the Git repo and how these will be applied. Unfortunately, it doesn’t show you too much detail on the way changes will be applied (i.e. dimension elements added or removed), but you can see all of this by comparing files in Git.
and you execute the plan the same way as the push plans.
### Execute pull plan
POST {{tm1_url}}/api/v1/GitPlans('{{git_pull_plan_id}}')/tm1.Execute HTTP/1.1
Authorization: Basic {{tm1_user_name}} {{tm1_user_password}}
content-type: application/json
You can view the current plans via this call:
### List plans
GET {{tm1_url}}/api/v1/GitPlans HTTP/1.1
Authorization: Basic {{tm1_user_name}} {{tm1_user_password}}
content-type: application/json
My setup is the following:
Installing all of the above would take you all of half an hour :)
Kinda self explanatory, fill in the paramters in the first 10 lines of the file.
rest-client.timeoutinmilliseconds:0
# TM1 settings
# IP or servername where TM1 server runs
@tm1server_ip=192.168.174.169
# HTTP Port Number in tm1s.cfg
@tm1server_port=12345
@tm1_url=https://{{tm1server_ip}}:{{tm1server_port}}
# Integrated Security 1 credentials
@tm1_user_name=admin
@tm1_user_password=apple`
# git credentials
@git_user_name=
@git_user_password=
@git_user_email=
@git_repo_url=

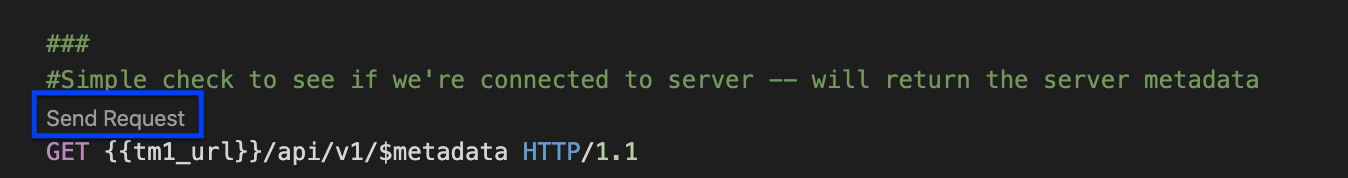

If you have Rest Client installed in VSCode, you’d have a ‘Send Request’ button underneath each request. Clicking it sends the request :)
